Why Coolnetpower for an AI-Driven Thermal Optimization Platform? A Procurement-Ready Review

If you’re a distributor or SI building client-ready packages for AI and high-density deployments, “AI-driven thermal optimization” is only useful if it’s integratable, auditable, and safe.

This review is written for procurement and supply-chain leads who need to shortlist vendors without relying on vague outcome claims. We’ll focus on what Coolnetpower’s stack covers (thermal optimization + liquid cooling + DCIM/monitoring), how it integrates into real facilities, what evidence you should request (when public metrics and named references aren’t available), and how to de-risk the decision with a structured on-site PoC.

Table of Contents

Verdict (one sentence)

Coolnetpower is a strong shortlist candidate when you need an integrated cooling + monitoring/DCIM foundation and a supervisory optimization layer that can be verified through commissioning artifacts (point lists, logs, and acceptance criteria) rather than marketing promises.

Who this is for (and who it isn’t)

Shortlist Coolnetpower if you’re…

  • packaging repeatable high-density / AI retrofit programs for multiple client sites

  • operating mixed environments (air + liquid, phased upgrades) and can’t afford a rip-and-replace approach

  • willing to run a PoC with clear constraints, change control, and measurable acceptance checks

Be cautious if you’re…

  • expecting public, pre-published performance guarantees (those require site-specific measurement programs and contractual terms)

  • unable to instrument, tag, and validate telemetry (no data readiness = no credible optimization)

  • unwilling to define “who owns what” across BMS/DCIM/controls teams

Key takeaways

  • Coolnetpower’s offering is best understood as an integrated stack: cooling + optional liquid cooling + DCIM/monitoring + an AI-driven supervisory optimization layer.

  • For distributors/SIs, the practical differentiator is delivery readiness: point lists, alarm ownership, rollback behavior, commissioning artifacts, and operator training.

  • Integration openness matters most at the interfaces you’ll touch: BACnet at the BMS layer and Modbus across power and many plant components.

  • You can validate value without hype by demanding a PoC acceptance criteria pack (safety envelopes, control conflict checks, audit logs, and rollback tests).

  • Lock-in risk is usually visible early: if you can’t export trends/events and can’t trace decisions back to inputs, you’re buying a black box.

AI-driven thermal optimization platform evaluation criteria (procurement checklist)

Use this as a shortlist filter when you’re comparing vendors or packaging an SI offering for multiple end clients. It’s structured around what creates real project risk: integration scope, controls safety, documentation, and handover.

Evaluation dimension

What to ask

What good evidence looks like

What to watch for

Scope clarity

Which assets/loops are in scope (air + liquid + power + DCIM)?

A written boundary diagram + point list

‘End-to-end’ claims with no boundary model

Openness & interfaces

Exactly which interfaces use BACnet/Modbus?

Protocol map + sample register/point list

‘Supports X’ with no point definitions

Read vs. write governance

What is read-only vs closed-loop control?

A staged plan with a write-enable gate

Immediate closed-loop without baseline

Safety constraints

What constraints are enforced (ASHRAE envelopes, rate limits, deadbands)?

Documented constraint set + rollback test

‘AI will keep it safe’ without constraints

Auditability

Can we trace decisions back to inputs?

Change logs + decision traces + exports

No audit trail; black-box outputs

Data readiness

What telemetry is mandatory vs optional?

Data QA checklist + tagging schema

‘We can work with any data’

Commissioning

How is the PoC commissioned and verified?

Test scripts + acceptance criteria tables

‘We’ll tune it onsite’ with no plan

Ops handover

What training and SOP/MOP updates are included?

Training plan + handover pack

No operator enablement

Support model

Who supports after go-live (remote/on-site, response times)?

Support plan + escalation model

Undefined responsibilities post-handover

For a practical view of what data and tagging quality matter most before optimization, reference Coolnetpower’s internal data-readiness checklist (linked later in this article).

What “AI-driven thermal optimization” means in practice (and what it shouldn’t do)

Most buyers don’t need a machine-learning explainer. They need crisp answers to:

  1. Where does this sit in the control stack?

  2. What prevents it from breaking things when conditions change?

Supervisory optimization vs. controller replacement

In mature deployments, AI-driven thermal optimization is a supervisory layer that uses live telemetry, analytics, and constraints to recommend (or apply) bounded adjustments. It should not replace your local safety logic.

A practical model:

  • Local controllers (PLC/DDC/VFD logic, CDU controllers, CRAH controls, etc.) keep core safety and loop stability.

  • Supervisory optimization correlates signals across systems and proposes adjustments that reduce waste (for example, avoid overcooling or conflicting setpoints).

Procurement implication: a vendor that can’t describe boundaries (read vs. write points, override behavior, rollback, and alarm ownership) is a vendor that will create integration and commissioning risk.

The metrics buyers care about: PUE and WUE (definitions, not promises)

Two metrics show up in almost every modern data center thermal optimization RFP:

This article does not publish site outcome numbers. Instead, it shows you how to verify whether a platform can influence the drivers behind PUE/WUE without compromising reliability.

Safety guardrails: the ASHRAE thermal envelope

Any optimization story that ignores environmental envelopes is incomplete. As a baseline, require alignment to the recommended/allowable classes and limits summarized in the ASHRAE TC 9.9 “Thermal Guidelines” reference card (5th ed.).

Pro Tip: In your PoC, write the envelope constraints into acceptance criteria. “We operate safely” is not a test.

Coolnetpower capability snapshot (what you’re actually buying)

For procurement-grade evaluation, separate capabilities from proof artifacts.

Monitoring + DCIM foundation

Coolnetpower’s DCIM/monitoring layer is positioned as an operational foundation: asset views, environmental and power monitoring, alarms/events, and remote management.

Relevant references:

What you should ask to see in a demo (because it impacts deployment scope and cost):

  • alarm taxonomy and routing model (who gets paged, and when?)

  • asset naming conventions and tag model

  • trend retention, export formats, and audit log visibility

  • role-based access and approval workflows

AI thermal optimization functions (capability-level)

At a capability level, an AI-driven thermal optimization platform should support:

  • hotspot detection and risk prediction (early warning before excursions become incidents)

  • setpoint optimization under constraints (reduce unnecessary margin; avoid oscillation)

  • cross-domain correlation (connect IT load changes to thermal response)

Coolnetpower’s own framing of the closed-loop architecture is described in AI-driven thermal optimization for green data centers.

Operations enablement (often the real differentiator)

SIs win deals when delivery is repeatable. For procurement, “repeatable” means the vendor can provide:

  • commissioning workflow and test scripts

  • change control model (approval gates, rollback, versioning)

  • training plan (operator, controls engineer, commissioning)

  • handover artifacts (as-built maps, point lists, SOP/MOP updates)

If these are vague, downstream costs won’t be.

DCIM integration for thermal optimization (what to insist on)

Many “AI data center cooling” proposals fail at the same point: integration details.

Your goal is to eliminate two common failure modes:

  • Point ambiguity: unclear read/write point definitions and tagging.

  • Ownership ambiguity: unclear responsibility when alarms trigger or controls conflict.

Where Modbus typically shows up

In many data centers, Modbus is common across:

  • power meters and some UPS/PDU telemetry

  • plant equipment interfaces (varies by vendor/deployment)

  • some cooling subsystems and skids

Where BACnet typically shows up

BACnet is widely used at the BMS layer for:

  • air handling and room cooling equipment interfaces

  • schedules and supervisory setpoints

  • status/command points across HVAC components

The exact architecture differs by site, but procurement can still demand one consistent deliverable: a point list and boundary model.

Integration deliverables to request (RFP-ready)

Require a mapping table as an attachment to any proposal:

System / layer

Protocol

Read signals (examples)

Write points (examples)

Ownership boundary

Fail-safe / rollback

BMS / HVAC supervisory

BACnet

temps, humidity, fan status, valve positions

bounded setpoint adjustments (if allowed)

BMS retains safeties

revert to baseline schedules

Power chain monitoring

Modbus

kW, kWh, breaker states, UPS status

typically none

power systems owner

read-only in early PoC

Liquid loop / CDU

vendor-dependent

supply/return temps, pump state, alarms

bounded controls (if integrated)

CDU owns loop safety

local control precedence

DCIM / monitoring

protocol/API mix

alarms, events, trends

notifications, integrations

DCIM admin

export + audit logs

Key Takeaway: If the vendor can’t provide this table early, you can’t price risk.

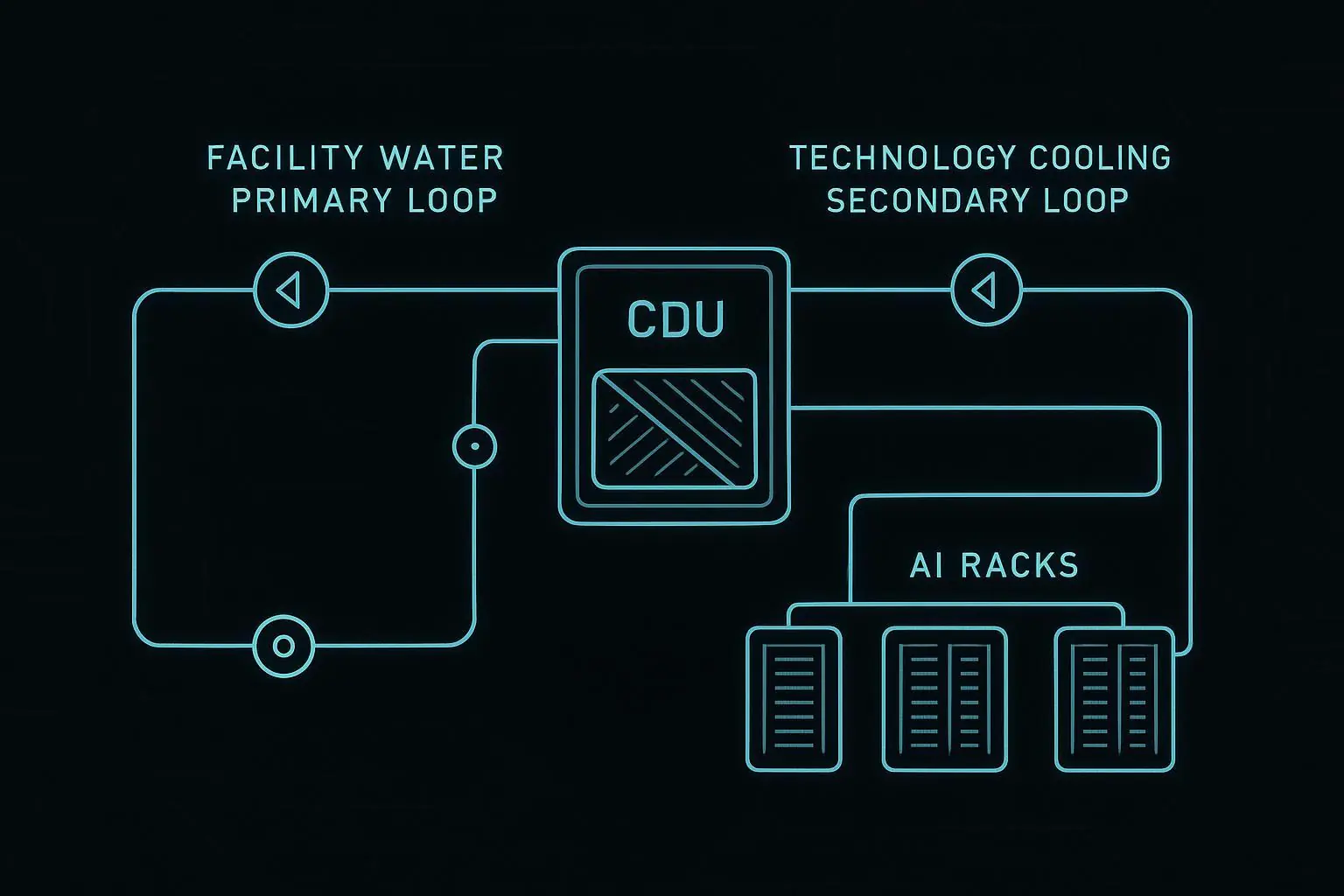

Liquid cooling integration (where a lot of risk lives)

High-density compute changes the thermal equation. For many sites, liquid cooling arrives before operational practices are ready for it.

From a partner delivery perspective, the best thermal optimization platform story is one that doesn’t ignore liquid loops.

What “liquid cooling monitoring and control” should mean (practically)

Even if you keep control loops local, procurement should expect the monitoring/optimization layer to support:

  • supply/return temperature observation

  • flow indicators (where instrumented)

  • pump/valve state monitoring

  • alarms signaling risk (pressure excursions, leak detection systems, etc.—site dependent)

The key isn’t naming every sensor. It’s making gaps explicit and testable.

Hybrid reality: air + liquid will coexist

Most sites run hybrid environments for years: some rooms or rows remain air-cooled while AI zones adopt direct-to-chip or other liquid solutions.

Coolnetpower’s liquid cooling framing can be used as a terminology reference for stakeholders and procurement documentation:

Coordination points to clarify before commissioning

SIs should push for explicit agreement on:

  • alarm ownership and escalation paths

  • change windows for optimization actions

  • rollback sequencing and “safe mode” behavior

If the answer is “we’ll figure it out onsite,” the cost will show up in commissioning hours.

Proof without published metrics: what to request (and what “good” looks like)

If you can’t publish numeric outcomes and can’t name customers, you can still run a procurement-grade evaluation by requiring a consistent evidence package.

Evidence pack checklist

Use this checklist to standardize vendor responses:

  • Trend package: timestamped trends for temperatures, key setpoints, and cooling states

  • Change log: what changed, when, why, and who approved it

  • Alarm/event logs: before/after during relevant change windows

  • As-built integration map: points, protocols, ownership, network zones

  • Rollback test record: documented revert-to-baseline procedure and results

  • Operations pack: SOP/MOP updates plus training completion records

⚠️ Warning: A platform that can’t provide audit logs and change traces is hard to defend in a multi-stakeholder procurement process.

How to evaluate PUE/WUE impact without publishing numbers

Even if you never publish the number, you can validate whether the platform affects PUE/WUE drivers by checking:

  • whether thermal safety margins are reduced without increasing excursions

  • whether control conflicts are reduced (fewer oscillations, fewer competing setpoints)

  • whether cooling is better aligned to actual IT load patterns

Coolnetpower’s internal explanation of the mechanism is a useful cross-reference for the engineering team:

Integration test questions to include in your PoC (make it measurable)

If you want procurement-grade confidence, write the integration tests into the PoC—not as “nice to haves,” but as pass/fail checks. Below are tests that are simple to run and hard to fake.

Point mapping and tagging tests

  • Test: Spot-check 30–50 critical points (temps, setpoints, device states) end-to-end from source system → monitoring/analytics layer.

  • Pass condition: point names match the agreed dictionary; timestamps are time-synced; units are consistent; missing values are explicitly flagged.

Read/write boundary tests

  • Test: Demonstrate a “read-only” mode with no write capability enabled, then show the formal gate to enable writes.

  • Pass condition: write-enable requires explicit approval; every write generates an audit log entry with who/when/why.

Control conflict detection

  • Test: Create a scenario where two systems could fight (for example, a BMS schedule change while optimization is active).

  • Pass condition: the platform detects the conflict and defaults to the agreed owner (usually BMS/local controls), with alarms and traceability.

Rollback / safe-mode drills

  • Test: Trigger a rollback drill during a controlled window.

  • Pass condition: the site returns to baseline controls within the agreed time, and the rollback procedure is repeatable.

A simple on-site PoC plan (timeline + acceptance criteria)

Below is a procurement-friendly PoC that an SI can quote and deliver.

Timeline (example: 6–10 weeks)

Phase

Typical duration

What happens

Deliverables you can audit

Scope + data readiness

1–2 weeks

define zone, confirm signals, define constraints

point list draft, data QA checklist

Integration + tagging

1–2 weeks

connect sources, normalize names, validate time sync

as-built integration map, tag dictionary

Observation mode

2–3 weeks

read-only monitoring, establish baseline patterns

baseline trend pack, anomaly list

Constrained optimization

2–3 weeks

bounded changes under change control

change logs, rollback test results

Reporting + handover

1 week

summarize evidence and operational impacts

PoC report, SOP/MOP updates, training sign-off

Acceptance criteria (example)

Criterion

How measured

Pass / fail rule

Evidence artifact

Safety envelope compliance

inlet temps/humidity vs defined limits

no unapproved violations

trends + alarms

Control conflict avoidance

oscillation checks, competing setpoints

no persistent conflict patterns

control logs

Rollback works

simulated override scenario

revert to baseline within agreed time

rollback test record

Alarm ownership works

alarm routing test

correct team receives and acknowledges

ticket/alert logs

Operator readiness

training completion

required roles complete training

training records

If you want a one-page “PoC acceptance criteria pack” as a downloadable asset, this table is already the backbone.

Compliance and documentation for procurement (certifications + approval pack)

Procurement teams don’t buy “trust.” They buy documentation.

Certifications/standards to verify

For this post, the correct procurement-safe wording is:

  • ISO 9001 / ISO 14001 / ISO 27001 — available in the compliance pack upon request

  • CE / UL / RoHS — available in the compliance pack upon request

Compliance pack checklist (what to request)

  • certificates and scope statements (what entities/sites are covered)

  • product compliance declarations relevant to your region

  • test reports where applicable

  • supplier quality process summary and change notification policy

Documentation that accelerates approvals

Ask for a standardized delivery pack:

  • datasheets (cooling, liquid cooling components, monitoring)

  • wiring and network diagrams

  • protocol maps and point lists (BACnet/Modbus)

  • commissioning checklist and test scripts

  • spares/parts plan and response SLAs

  • training plan and handover documents

Openness, standards, and avoiding vendor lock-in

“Open” is only meaningful if it’s testable.

What openness should mean (practical definition)

  • documented point lists for BACnet/Modbus integration

  • exportable trends and event logs (for reporting and audits)

  • clear separation of responsibilities (BMS vs supervisory optimization)

Vendor lock-in red flags

  • proprietary-only gateways with no documented point model

  • control actions you can’t trace back to inputs (no audit trail)

  • inability to export historical data in usable formats

If you see these early, it’s usually cheaper to stop than to “fix it later.”

Pros, cons, and fit guidance (detailed)

This is the section most partner/procurement readers use to make a shortlist decision.

Pros (why Coolnetpower can be a strong SI/distributor fit)

  1. Integrated stack reduces coordination overhead

    • A single vendor covering cooling, optional liquid cooling components, and monitoring/DCIM reduces interface risk and “vendor A vs vendor B” deadlocks.

    • For partners, that often translates into fewer subcontractor boundaries and fewer late-stage integration surprises.

  2. A supervisory optimization posture fits real facilities

    • Most sites can’t afford disruptive control migrations.

    • A supervisory layer that respects existing controllers is easier to deploy, govern, and audit.

  3. Evidence-based procurement is achievable without public outcome numbers

    • The required artifacts (point lists, logs, rollback tests, acceptance criteria) let you verify operational impact in your own site context.

    • This is often a better procurement posture than relying on marketing benchmarks that may not match your climate, load profile, or constraints.

  4. Clear integration standards focus: DCIM integration via BACnet/Modbus boundaries

    • Predictable scoping is a procurement advantage.

    • If you can standardize your point model and ownership boundaries across projects, you reduce delivery variance.

  5. Partner delivery readiness (what to look for in practice)

    • repeatable PoC plan

    • documented change governance and rollback

    • training and handover assets aligned to ops realities

Cons / trade-offs (what could slow results or increase hidden cost)

  1. Data readiness is the gate—and it’s not optional

    • If sensor coverage is incomplete, timestamps drift, or tagging is inconsistent, optimization becomes guesswork.

    • The practical solution is to treat data readiness as a contractual scope item with pass/fail checks.

  2. Integration effort varies widely by “what you already have”

    • Two sites can both “have BACnet,” but differ in: naming standards, segmentation rules, permission models, and change governance.

    • Expect real effort in mapping, validating, and documenting the interface—not just “connecting.”

  3. Closed-loop optimization requires change control maturity

    • If your client cannot define who approves changes, when changes are allowed, and how rollbacks are executed, you’ll be stuck in observation mode.

    • That’s not a vendor failure; it’s an operational readiness gap that must be addressed.

  4. Liquid cooling increases stakeholder count and commissioning complexity

    • The moment you touch CDUs and liquid loops, you add owners (mechanical, facilities, IT, and sometimes OEMs).

    • Procurement should price for additional integration workshops, test windows, and acceptance checks.

  5. Lock-in risk is mostly about auditability, not protocol logos

    • A vendor can support Modbus/BACnet and still behave like a black box if the decision trace isn’t visible.

    • Make exportability and traceability explicit requirements.

Best fit / not best fit

Best fit:

  • distributors/SIs delivering repeatable AI-density upgrade packages

  • sites planning hybrid (air + liquid) thermal architectures

  • organizations able to run a structured PoC with documented acceptance criteria

Not the best fit (or needs extra planning):

  • sites unwilling to instrument/validate data and define control boundaries

  • procurement processes that require hard public guarantees up front without allowing a PoC

Training and handover: what good looks like for ops teams

Procurement teams often underestimate this: thermal optimization only sticks if operators trust it. In practice, that requires training that is specific to your control boundaries and your alarms—not generic product training.

Minimum training tracks (partner-ready)

  • Operator track (day-to-day): dashboards, alarms, what actions are automated vs manual, and what to do during excursions.

  • Controls/commissioning track: point mapping, constraint configuration, change windows, and rollback drills.

  • Operations documentation track: how SOP/MOP documents are updated, approved, and versioned.

Handover artifacts to require

  • As-built point list + tag dictionary

  • Alarm taxonomy and escalation matrix

  • Change control and rollback runbook

  • PoC final report with acceptance criteria results

If a vendor can’t deliver these artifacts cleanly, the SI ends up owning the ambiguity—and the cost.

Next steps

Two low-friction actions reduce procurement risk fastest:

  1. Request a BACnet/Modbus integration point list template + evidence pack checklist.

  2. Run a 6–10 week on-site PoC using the acceptance criteria above, then decide based on artifacts—not adjectives.

For teams who want an internal evaluation framework before engaging vendors, start with: Data requirements for AI thermal optimization: a practical checklist.

FAQ (procurement questions that come up every time)

Can Coolnetpower integrate with our existing liquid cooling?

Yes—if you treat it as an integration scope item. The practical question isn’t “can it,” but which signals are available from your CDUs/loops, via which interface, and who owns safeties. In procurement terms, require the point list, boundary model, and rollback drill in the PoC.

What PUE/WUE improvements has Coolnetpower delivered?

This article intentionally does not publish site outcome numbers. The procurement-safe way to evaluate impact is to run a constrained PoC and review the evidence pack: trends, change logs, conflict checks, and envelope compliance. If a vendor can’t provide auditable artifacts, the numbers won’t be defensible anyway.

Can we run a risk-controlled on-site PoC?

Yes. Use the 6–10 week plan and acceptance criteria tables above. The most important risk control is a staged rollout (read-only → constrained optimization) and a tested rollback procedure.

What training should we require for our ops team?

At minimum: operator workflow training, controls/commissioning training, and documented SOP/MOP updates—plus an escalation matrix. If these are missing, adoption usually stalls after the PoC.

How do we avoid vendor lock-in?

Make openness testable: insist on exportable trends/events, a documented point model, an auditable change log, and a clear boundary statement that keeps local safeties local. Protocol logos alone don’t prevent lock-in.

Facebook
Pinterest
Twitter
LinkedIn

Leave a Reply

Your email address will not be published. Required fields are marked*

Tel
Wechat
