Start with what is being cooled
Direct-to-chip cooling uses cold plates to remove heat from selected components, typically the highest-load processors. Heat from components outside that liquid path may still enter the room air and must be included in the cooling plan.
Immersion places compatible IT equipment in a dielectric fluid. This changes both the heat-capture arrangement and the service environment. The choice is therefore about more than a cooling unit: it affects hardware qualification, layout, maintenance and the facility interface.
Compare the changes to the existing site

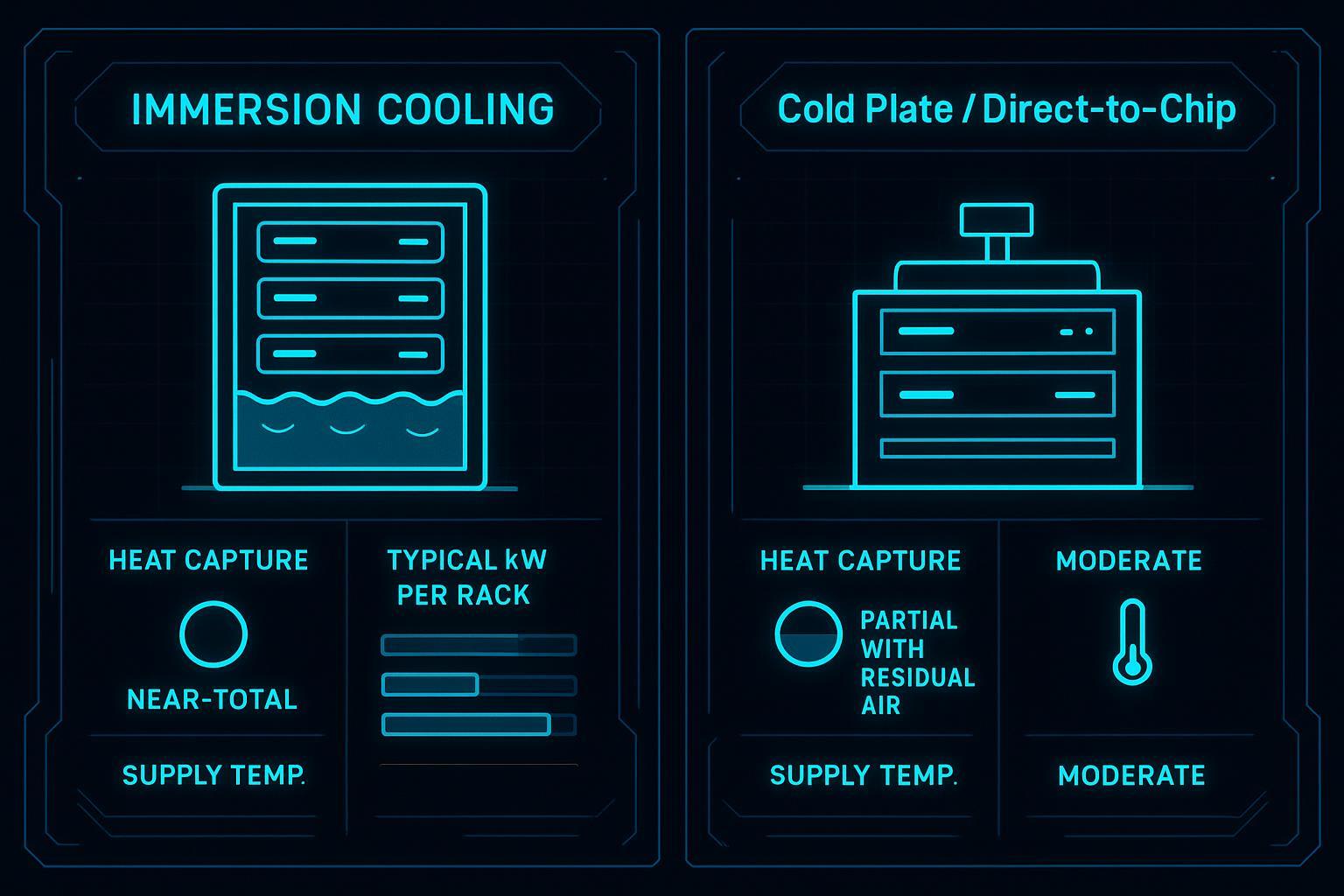

A cold-plate deployment can often be organized around a rack row or a defined zone. It introduces liquid distribution, manifolds, connectors and a CDU or other specified facility interface. Existing air cooling may remain necessary for the residual load.
An immersion deployment requires attention to tanks, floor loading, access clearances, fluid handling and the process for removing and servicing equipment. A building designed around those requirements presents different options from an occupied hall with restricted change windows.
The most suitable approach depends on the workload, compatible IT equipment and the amount of change the site can accommodate. Rack density alone does not determine the answer.
Both approaches need a heat-rejection plan
Liquid transports heat; it does not make the heat disappear. Both architectures need a defined path to the facility’s heat-rejection system. Review coolant temperatures, flow, materials and the interface between the IT loop and the plant.
Energy or water comparisons should use the same measurement boundary and operating assumptions. A favorable result at one component does not establish a facility-wide PUE or water-consumption result. Heat reuse also depends on the temperature of the recovered heat and the availability of a suitable recipient.
Design the operating procedures early
Cold-plate systems require controlled handling of hoses, quick disconnects and manifolds. Immersion introduces a different set of fluid-containment and equipment-handling tasks. Both need trained operators, compatible materials and a defined response to alarms or a loss of cooling.
Confirm the permitted coolant, filtration requirements and sampling or maintenance plan with the relevant equipment suppliers. Do not assume that fluids, connectors or server components from different systems are interchangeable.
- Define leak detection, isolation and recovery procedures.
- Verify fluid and wetted-material compatibility.
- Include service access and equipment-handling requirements in the layout.
- Map temperatures, flow and alarms into the operating system.

Use a staged deployment to test the assumptions
A pilot zone can help the team validate the interfaces and service model before a wider rollout. The acceptance plan should cover representative load, cooling control, monitoring and the agreed fault responses.
Keep the final choice connected to the facility’s growth plan. Cooling, protected power, physical layout and operator readiness need to advance together for a liquid-cooled zone to become a maintainable part of the site.
